Layout Plan
The Project scope includes (the letter corresponds with the layout plan below):
- ADA accessible sidewalk connection from the roadway to the beach (D)
- ADA accessible boardwalk along the beach front (H)
- Resurfacing and reconfiguration of the north parking lot for improved vehicular and boat access (A)
- Native landscaping (I)
- Signage
- Site Lighting
- Alternate Bid: Pergola at beach front
The Park District hired Hitchcock Design Group (HDG) to take the concept plan through to implementation.
The layout plan below builds on the approved concept plan and is based on a survey of existing conditions, dimensions, and utilities. The layout plan will be shared with the Park Board at a public meeting on October 4, 2023. HDG will then complete the construction documents for the project to be bid out this fall.
Plan Details
Phase 1
This phase is funded through the OSLAD grant award and Park District capital budget. (Highlighted in the red dotted line in illustration below)
Highlights of the plan include:

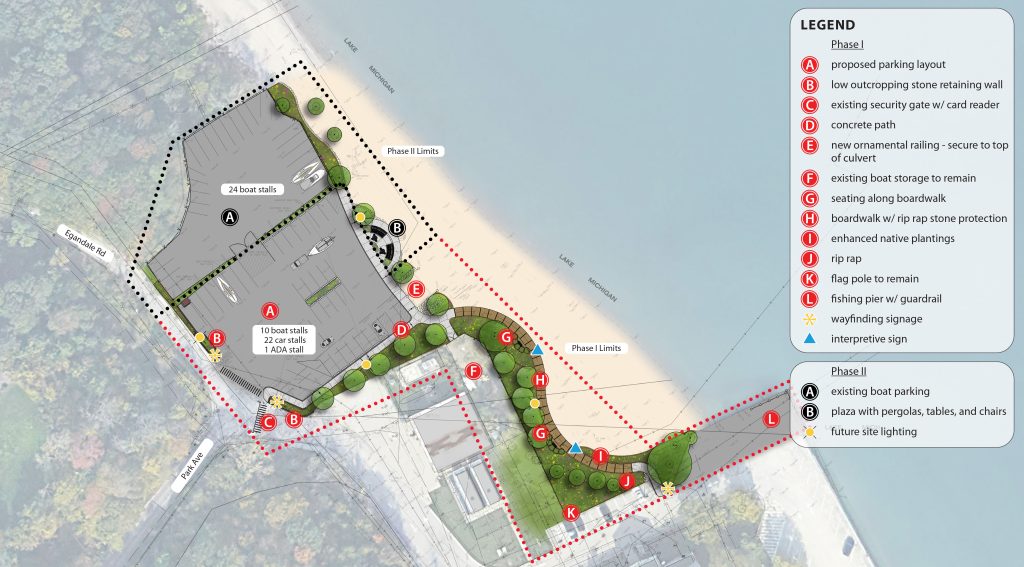

A: Reconfigured parking lot for improved circulation, landscaping, and viewing of the Lake.
D: New concrete sidewalk for easier beach access for pedestrians walking to the beach.

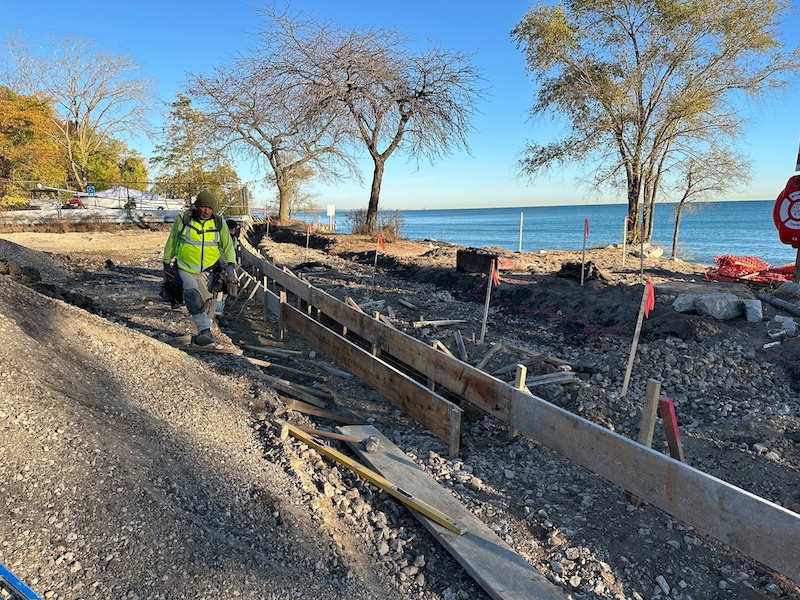

H: New accessible boardwalk along the beach, improving access to the beach and circulation around Park Avenue Boating Facility.
G: Seating along the boardwalk.
Phase 2:
This phase is unfunded. These elements will be designed and bid as alternates to Phase 1, and if funding is available, Phase 2 will be implemented. (Highlighted in the black dotted line in illustration below)
Highlights of the plan include:
A: The fenced boat parking will not be resurfaced as part of this project but has been identified as a future need.
B: Plaza with pergola, tables, and chairs to enhance patron experience as the beach and provide space for gathering and passive use.
Please note: Park Ave construction begins in September. See new parking configurations.
Process
Districtwide planning efforts, including the Park Avenue Site Master Plan, Beach Management Plan, and the Lakefront Master Plan, support the Park Avenue Access Improvement Plan These plans were enhanced by engagement with the community and patrons of the Park Avenue Boating Facility.
OSLAD Grant Application Submitted
Review Proposals and Award Design Contract
Design
Design Development/Construction Documents
PROJECT UPDATES
STAY UP TO DATE ON THE LATEST RENOVATIONS

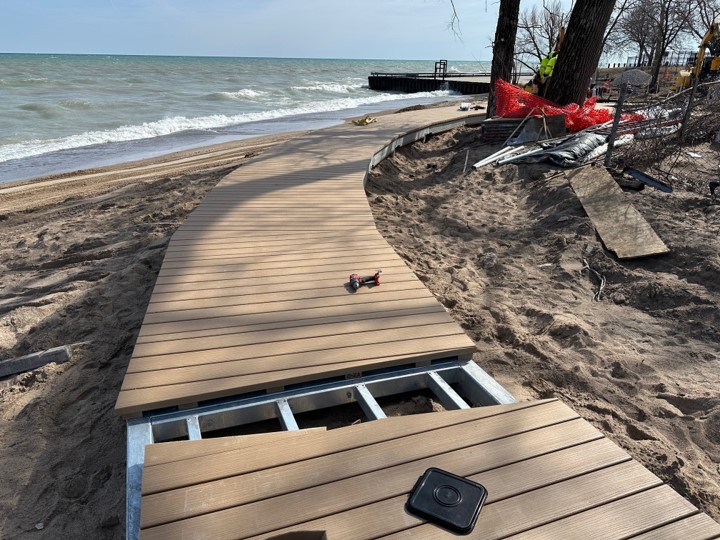

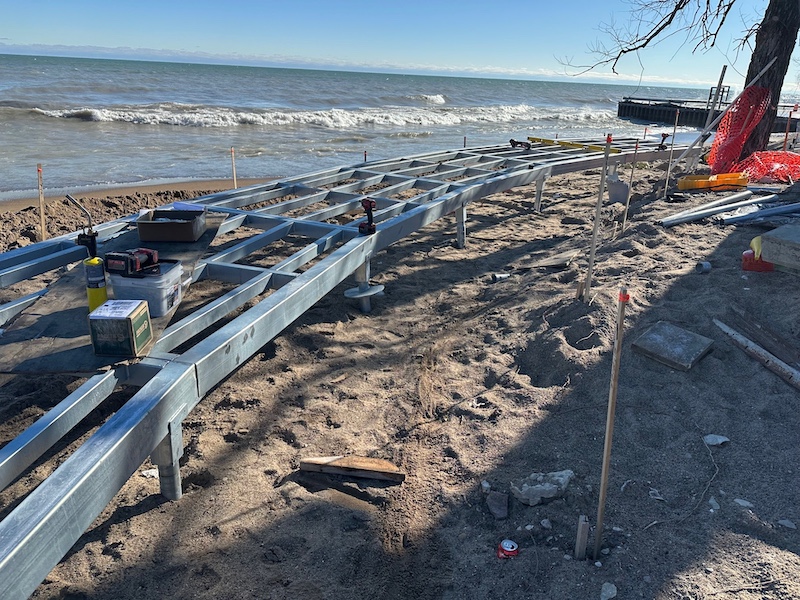

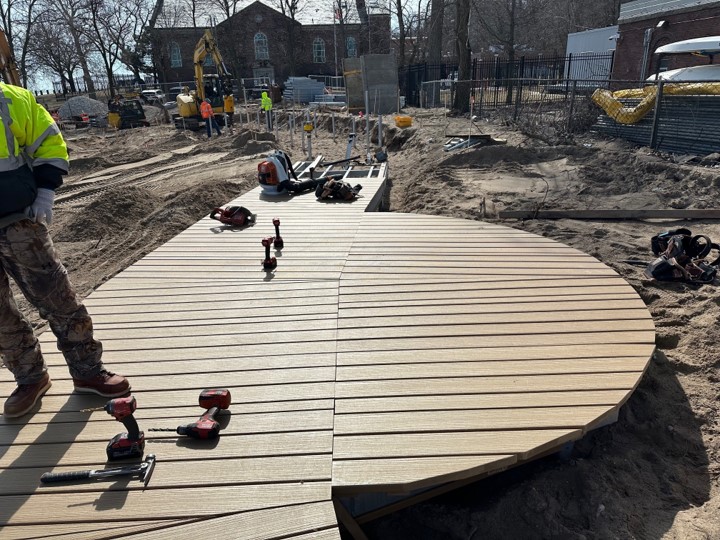

December 20, 2024
The Park District is working with the contractor to continue construction throughout the winter and construction will occur weather permitting.
December 20, 2024
December 11, 2024
New plants have been installed in the beds.
December 11, 2024
December 3, 2024
The parking lot improvements have been completed.
New asphalt has been installed and the lot has been striped.
December 3, 2024
November 19, 2024
Prep work to install the asphalt parking lot is underway
November 19, 2024
November 14, 2024

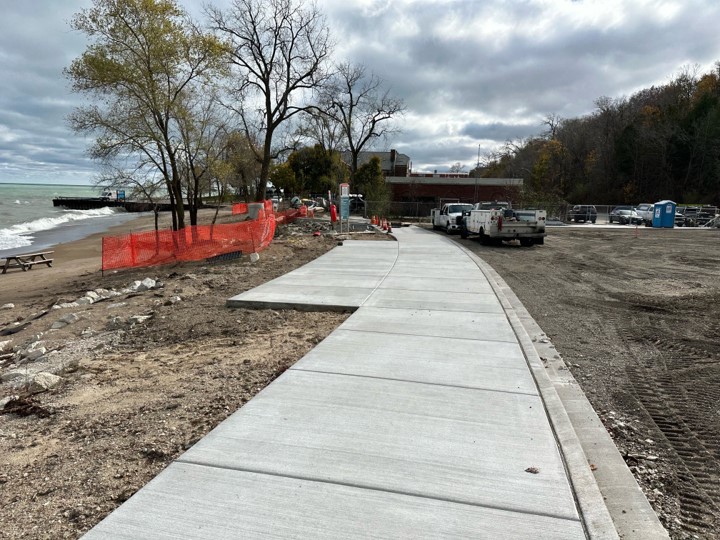

Concrete curbs, sidewalks, and the overlook have been completed.
November 14, 2024
October 30, 2024

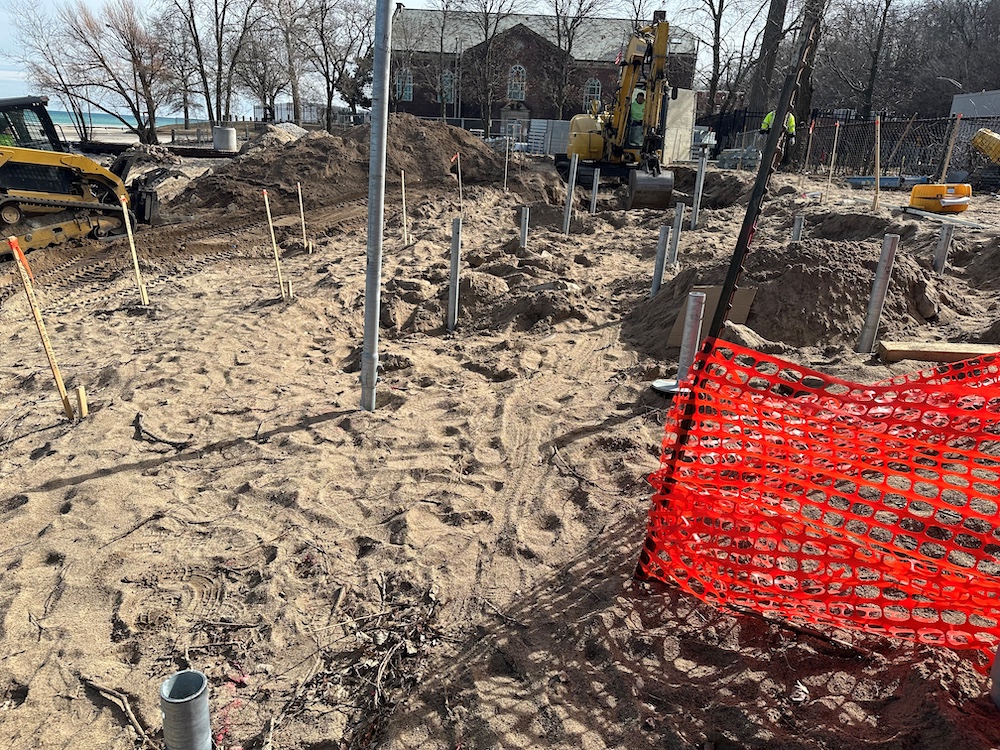

Installation of the concrete walk has started
October 30, 2024
October 25, 2024
Framing of the curb and walkway is underway.
October 25, 2024
October 17, 2024
Demolition of the parking lot is underway.
October 17, 2024
October 2, 2024
The construction fence has been installed.
October 2, 2024
September 27, 2024
Construction is expected to begin the week of September 30. Construction fencing on site will go up and excavation work will begin.
September 27, 2024
August 28, 2024
Construction is now expected to begin the week of September 9. Construction fencing will go up that week.
August 28, 2024
July 5, 2024
Construction is expected to begin September 3.
July 5, 2024
